Nimbin Roadworks

Share on Facebook Share on Twitter Share on Linkedin Email this link

Project update June 2021

The time frame for the completion of roadworks on Nimbin Road and Blue Knob Road has been adjusted. Unfortunately the works have been delayed and the new expected completion date for all sites is September 2021. The delays have been caused by a number of reasons including a month of wet weather, contractor availability and unforeseen site conditions caused by the subsurface being poorer than expected and affected by weather. The order in which the work will be completed at each site has also been adjusted due to the availability of contractors.

Please find the revised time frame of works updated on the 18 June 2021.

Expected time frame of works
Location
Site number
15 March 2021 - 19 July 2021

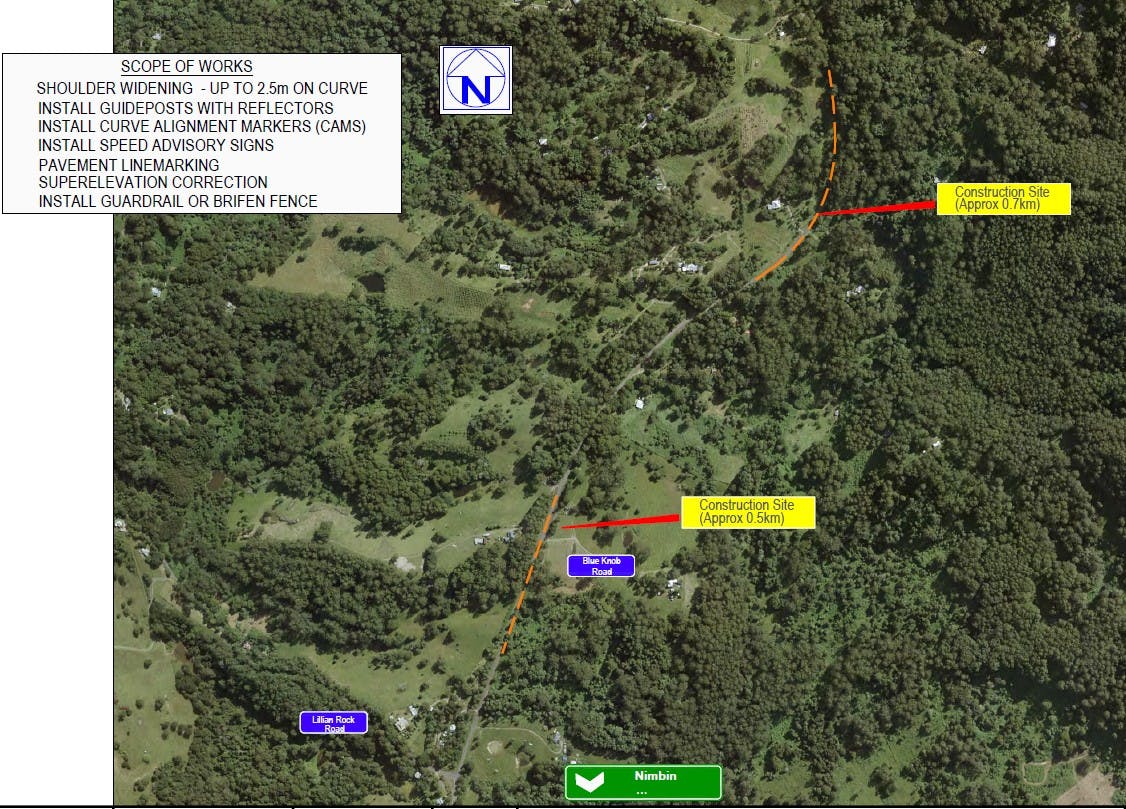

Approximately 500m section starting north of Lillian Rock Road and approximately 700m section on the curve outside 864-867 Blue Knob Road
Site 24

21 May 2021 - 25 June 2021

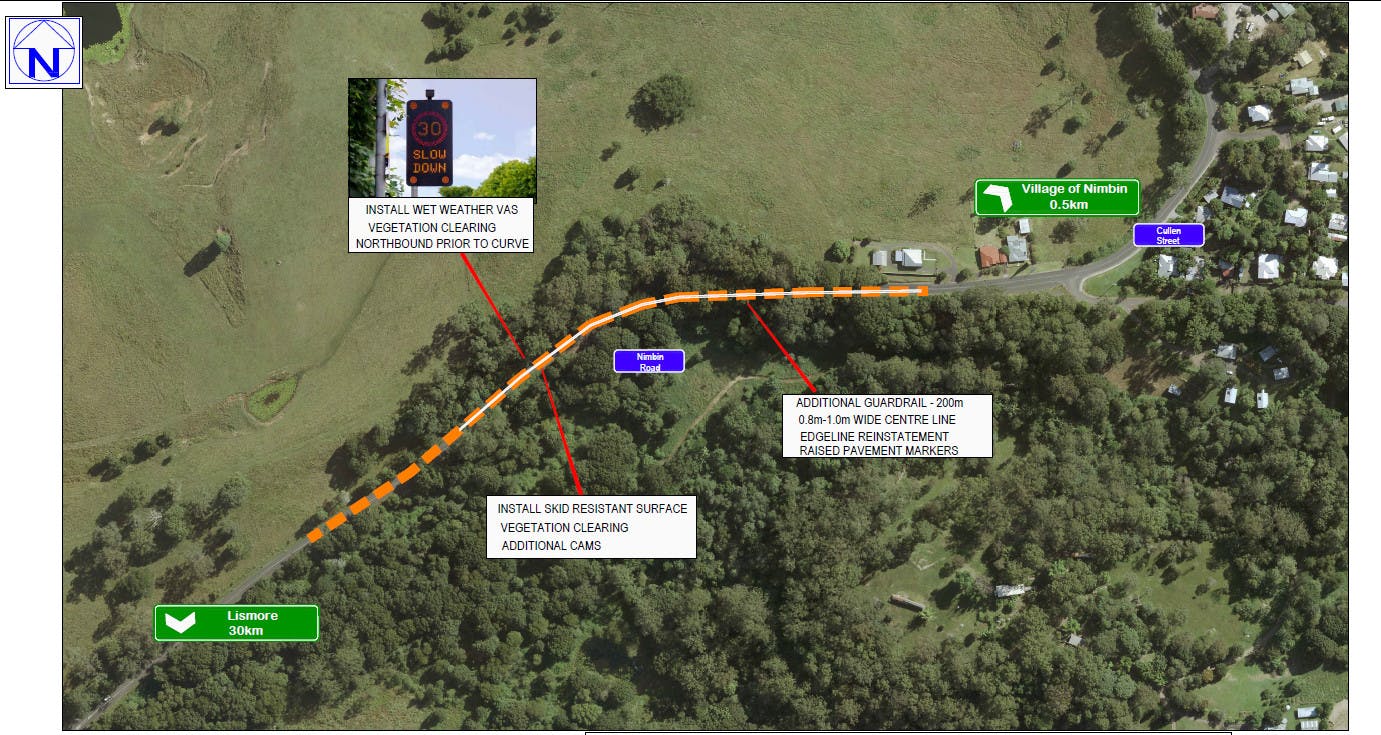

0.3km section of Nimbin Road situated 0.5km south of Nimbin Village

Site 22

21 June 2021 - 22 July 2021

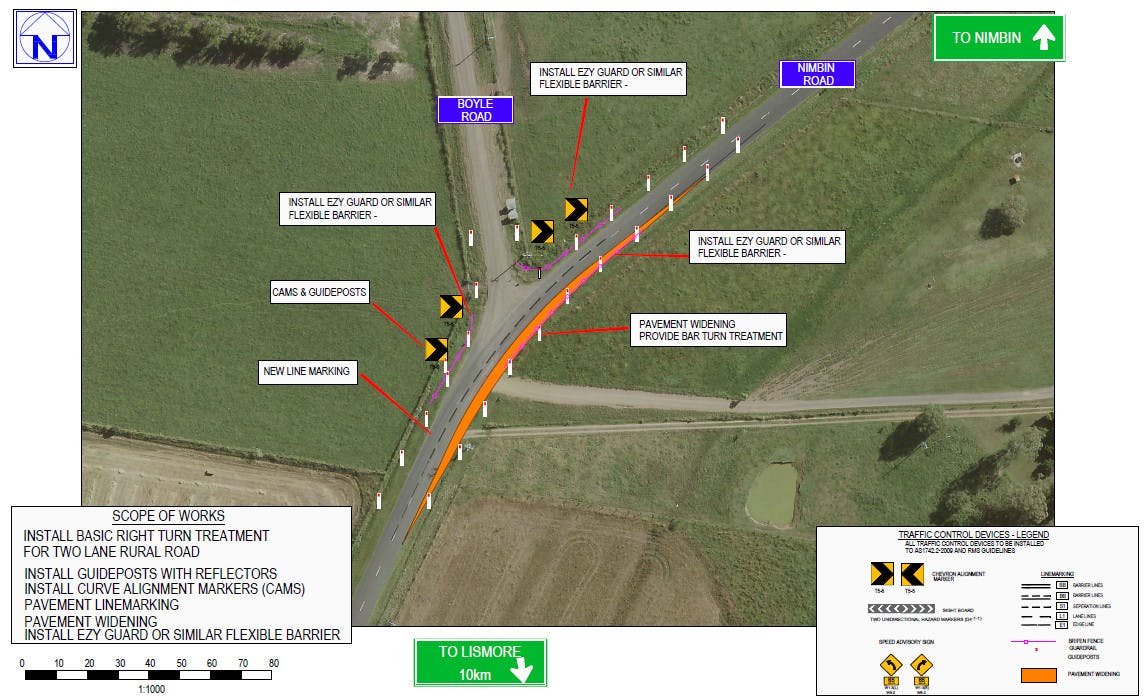

0.2km section of Nimbin Road at intersection with Boyle Road, Goolmangar

Site 23
8 July 2021 - 3 September 2021

1km section of Nimbin Road situated approximately 1.3km – 2.3km north of Boyle Road intersection

Site 20

9 July 2021 - 21 September 2021

0.6 section of Nimbin Road situated approximately 0.2km – 0.8km north of Boorie Creek Road

Site 19
9 July 2021 - 15 September 2021

0.3km section of Nimbin Road, situated approximately 0.2km-0.5km North of Old Quarry Road

Site 18
12 July 2021 - 23 August 2021

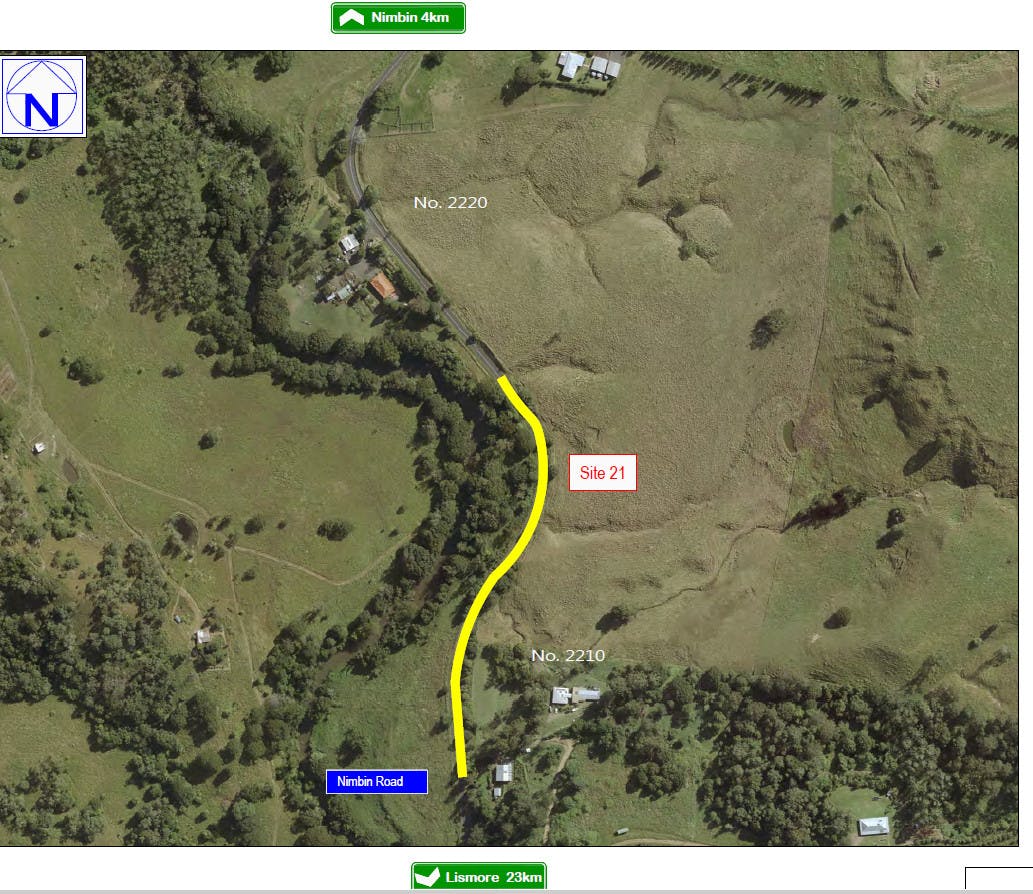

0.4km section of Nimbin Road approximately 3.5km south of Nimbin Village
Site 21


Council is undertaking roadworks along Blue Knob and Nimbin Roads.

The roadworks will take place along Nimbin Road and one site on Blue Knob Road.

Works are expected to take about five to six months to complete, subject to weather. Daily work hours are 7am to 6pm on weekdays and 7am to 1pm on Saturdays.

The work taking place on each site will vary depending on identified safety issues. Following is a list of road safety treatments that will be applied as appropriate to the safety needs at each location:

  • Road widening or changing the road.
  • Resurfacing or ‘heavy patching’ of the road.
  • Road drainage improvements such as kerb and guttering, pipe culvert extension and table drain maintenance.
  • Road delineation works including line marking and guide posting.
  • Road advisory signage including curve advisory markers and speed advisory signs.
  • Sight distance improvements including vegetation removal and embankment trimming.
  • Driveways and farm gates that intersect the road will be amended to match any changes to the road

Council will have traffic control operators in place during working hours, with portable traffic lights in place at times depending on the daily or weekly construction methodology and scope.

We apologise for the disruptions you may experience whilst we upgrade Nimbin and Blue Knob Roads. Please be patient and commute through roadworks sites at low speed, obey traffic control instructions and drive carefully.

If you have any concerns or questions, please phone Project Manager Joe Lokic on 0436 660 035 or ask us a question online below via our Q&A.

For enquiries outside of normal working hours, please phone 1300 87 83 87 (24-hour service).
